Faith
Church retreat planning timeline: a 12-week example and checklist
Adapt a twelve-week retreat timeline with example dates, named owners, and a printable arrival checklist. Includes a free editable worksheet for your ministry team.

Free planning tools
Church retreat timeline worksheet
Work backward from arrival day with owners and an adaptable retreat timeline.
No signup required.
In this guide
Use this church retreat planning timeline to turn an arrival date into decisions, deadlines, and named owners. Start with the twelve-week example below, then adapt the free editable timeline and printable checklist to your ministry team and venue.
A retreat begins with a reason to gather. Before comparing venues or writing the invitation, finish one sentence together: “We want people to leave this weekend with…” That answer will help you decide what belongs in the schedule, what can wait, and where the team should spend its attention.
The timeline below is an illustrative twelve-week plan for a two-night, 48-person adult retreat. It is a planning example, not a minimum lead time or a claim about a real ADGEvents customer. Venue deadlines, participant needs, and your organization’s policies may require an earlier start.
Download the editable retreat timeline or open the printable planning sheet. The worksheet includes example dates, a blank due-date column, and a blank owner column for your own plan. The download needs no signup.
Start with three decisions
Choose a planning owner, a purpose, and the decisions that need approval. The owner does not need to do every task. Their job is to make the next decision visible and bring unresolved items to the right person.
For our example, the purpose is connection across three ministry groups. The team chooses two shared meals, one facilitated conversation, and unstructured time rather than filling every hour. One person owns the venue relationship, another registrations, and a third the program. The ministry lead approves the budget and the final invitation.
Write those responsibilities beside the decisions. “Confirm meals” is incomplete until someone knows who will confirm them, with whom, and by when.
A 12-week church retreat planning timeline
For the fictional arrival date May 14, 2027, the milestones become the following dates. These are illustrative planning dates, separate from this article's publication date.
| When | Example due date | Decision or deliverable | Example owner | Ready when |
|---|---|---|---|---|
| 12 weeks before | February 19 | Purpose, budget boundaries, dates | Ministry lead | Approvals recorded |
| 10 weeks before | March 5 | Venue and room options | Logistics lead | Provider confirms arrangements |
| 8 weeks before | March 19 | Registration and invitation | Registration lead | A sample signup has been reviewed |
| 6 weeks before | April 2 | Sessions and volunteer roles | Program lead | Each role has an owner |
| 4 weeks before | April 16 | Rooming and participant requests | Logistics lead | Open questions have follow-up dates |
| 2 weeks before | April 30 | Arrival guide and team briefing | Planning owner | Details checked with providers |
| 1 week before | May 7 | Open decisions and backup owners | Planning owner | Each unresolved item has a next check date |
| 2 days before | May 12 | Latest roster and welcome materials | Welcome lead | Team can identify the current version |
| Arrival day | May 14 | Welcome desk and first handoffs | On-site lead | Roles and escalation contact are clear |
| 3 days after | May 17 | Unresolved issues and promised follow-up | Planning owner | Each promise has an owner and due date |
In this example, registration closes before the venue’s final room-count deadline. Work out that relationship using the provider’s actual agreement; do not copy a cutoff from another retreat without checking it.
Adapt the dates to your retreat
Enter your actual arrival date first. Work backward to the venue's room-count, meal, payment, and cancellation deadlines, then place your internal review before each one. The worksheet's example dates are plain text to replace; they do not recalculate automatically when you change the arrival date. Recheck the resulting dates with the owner and provider.
For example, suppose the fictional venue needs the final room count on April 23. The registration owner could choose April 16 as an internal registration review and reserve the following week for corrections. That is a planning choice for this example, not a venue rule. Record the confirmed provider deadline beside the internal due date so the two stay distinguishable.
Give each row one accountable owner even when several people help. Use a status such as not started, waiting on confirmation, ready for review, or complete. A row becomes complete when its “Ready when” condition is met. For a missing confirmation, keep the row open and add the next check date instead of moving the deadline without explanation.
Make the final week about confirmation
Separate a missing decision from a routine reminder. “Confirm dietary request with the caterer” is a task; “send everyone the same old planning thread” is unlikely to settle it. Maintain a short list of unresolved questions with a named owner and a next check date.
The participant arrival guide should answer: where to go, when to arrive, what to bring, what the first evening looks like, and whom to contact. Keep the staff running order separate from the participant version.
For the sample Friday arrival, the team plans a 4:00 p.m. welcome desk, a 5:30 p.m. meal, and a 7:00 p.m. first gathering. Each time appears consistently in the participant guide and team plan. The welcome lead checks the latest roster before opening. The program lead owns a delayed start decision, and the venue contact confirms whether a late arrival can still receive a meal. Adapt these arrangements to the actual venue and participant needs.
Descriptive headings help readers understand and navigate a page, including through assistive technology. The W3C headings tutorial explains this structure. Apply the same principle to an arrival guide: use “Where to park” instead of a vague heading such as “More information.”
Church retreat checklist for arrival day
- Venue details and arrival instructions checked with the venue.
- Rooming questions resolved or assigned to a named follow-up owner.
- Participant requests shared only with the people who need to act on them.
- Welcome desk has the current registration list.
- Volunteers know their first assignment and backup contact.
- First session, meal, and transition times agree across the itinerary and team plan.
- A final version date appears on any printed guide.
- The team has agreed how to communicate a same-day change.
Download the retreat timeline worksheet or print the matching planning sheet. Both contain the same example milestones. Fill in your own dates and owners, then check each deadline with the relevant decision-maker.
Give the team a shared running order

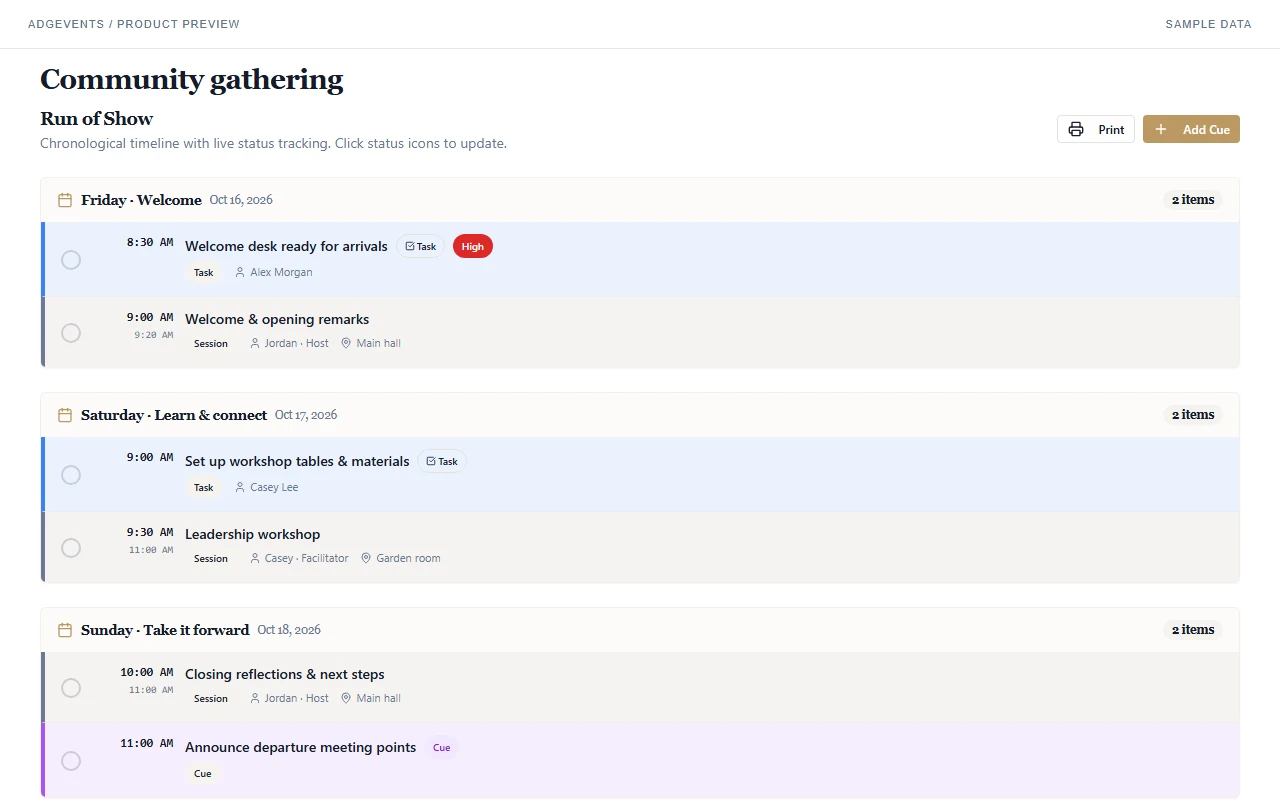

This actual product capture uses sample data. ADGEvents brings sessions, tasks, and cues into a run-of-show view. Use it to review the day with your team; it does not replace the approvals or provider confirmations in your plan.
